We build vessel collision warning systems for vulnerable bridges.

Roebling Labs assigns real-time threat levels to AIS-equipped vessels by combining transponder tracking, trajectory forecasting, and AASHTO impact analysis.

Problem

The Francis Scott Key Bridge collapse, with a life-loss of six and cost to society of five billion dollars, triggered an NTSB investigation that identified 68 potentially vulnerable bridges across the U.S.A. These bridges were built before 1996 over navigation channels serving ocean-going vessels and had not yet received modern risk assessments. As of April 2026, 45 bridges remain on the NTSB's vulnerable list as risk assessments are completed.

Francis Scott Key Bridge collapsed after contact with containership Dali on 28 March 2024

Figure 1: Francis Scott Key Bridge collapsed after contact with containership Dali on 28 March 2024. (Source: NTSB)

The twenty owner agencies responsible for the NTSB-named vulnerable bridges received letters on 10 December 2025 with safety recommendations enclosed.

NTSB Safety Recommendation H-25-030: "Incorporate motorist warning systems capable of activating when a threat is identified and immediately warn and stop motorists from entering the bridge."

Standards for installing traffic gates and marine radios are well established at movable bridges, for example. This NTSB recommendation implies that traffic gates be retrofitted to existing, vulnerable long-span bridges.

Bridge owners need vessel threat information to support time-critical decisions about operating traffic gates, contacting aberrant vessels, and protecting bridge users.

Solution

Roebling Labs builds vessel collision warning systems for vulnerable bridges.

The system assigns threat levels to AIS-equipped vessels by combining real-time transponder tracking, trajectory forecasting, and AASHTO impact analysis.

How your vessel collision warning system works

Conceptual Schematic

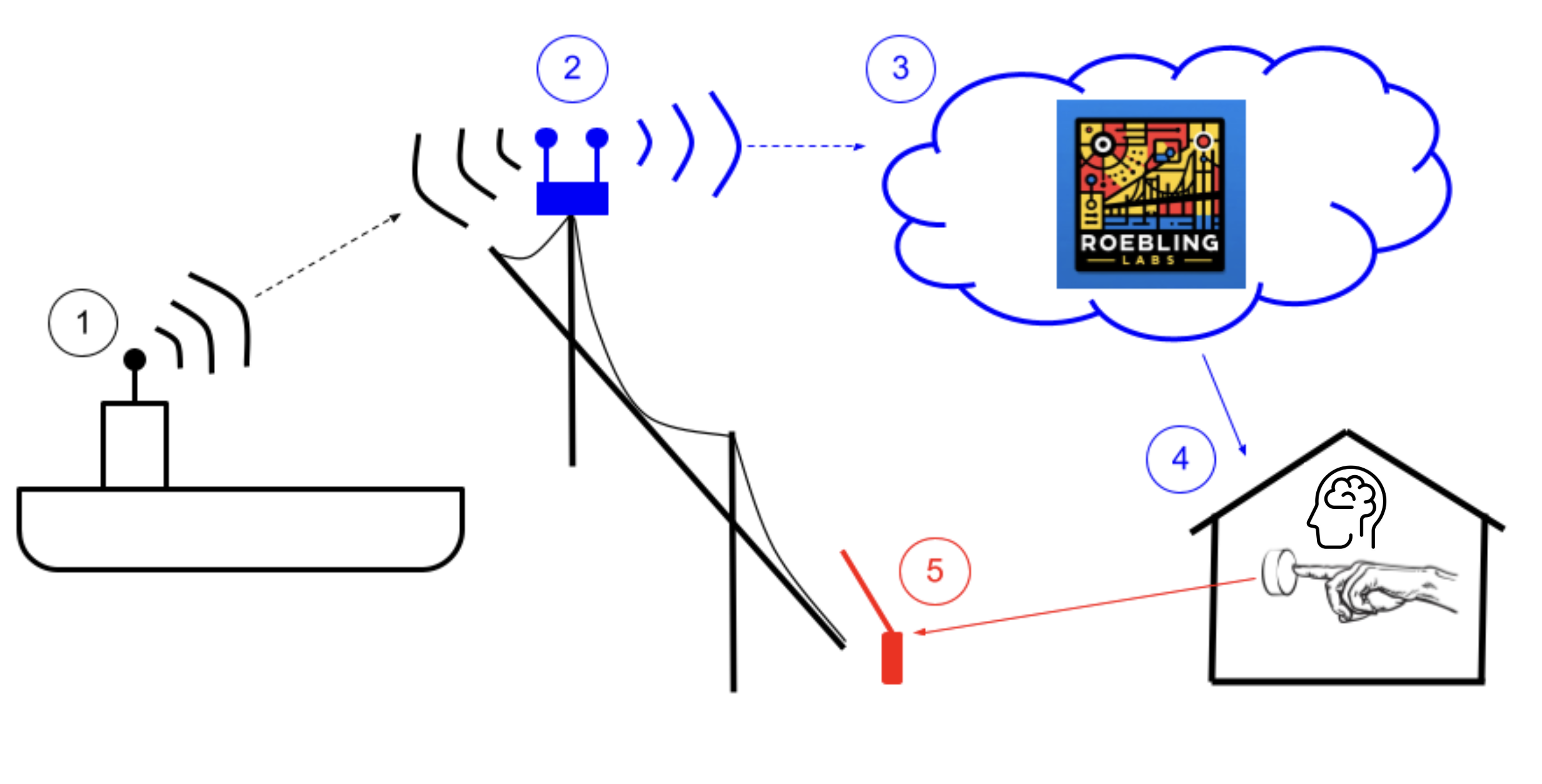

Figure 2: Schematic of Vessel Collision Warning System

  1. Ship: Vessels send AIS signals of identification, size, position, speed, and heading, per U.S. Coast Guard requirements since 2002.
  2. Bridge: Roebling Labs' box receives AIS signals, filters, and sends relevant data to the cloud.
  3. Cloud: Roebling Labs' cloud receives the data in real-time, runs our threat assessment algorithm, and transmits alerts when risk scenarios are detected. Important data is stored to investigate incidents and improve algorithm performance.
  4. Operations Center: Staff receive Roebling Labs' alerts via browser-based dashboard, API software integration, SMS message, or phone.
  5. Traffic Gates & Marine Radio: Bridge operations staff evaluate and respond to alerts as appropriate to communicate with vessels and close and open traffic gates.

Note: Roebling Labs' system provides risk information on AIS-equipped vessels to support decisions by bridge operators.

Optional computer vision enhancement adds visual verification of vessel data and detection of non-AIS vessels, such as a loose barge. Visual recordings support post-incident investigation and improvement of the threat assessment algorithm.

How we perform threat assessment

We provide real-time risk assessment of AIS-equipped vessels based on the probability of aberrancy and consequence of collision.

Risk Matrix for Assessing Vessel Threat

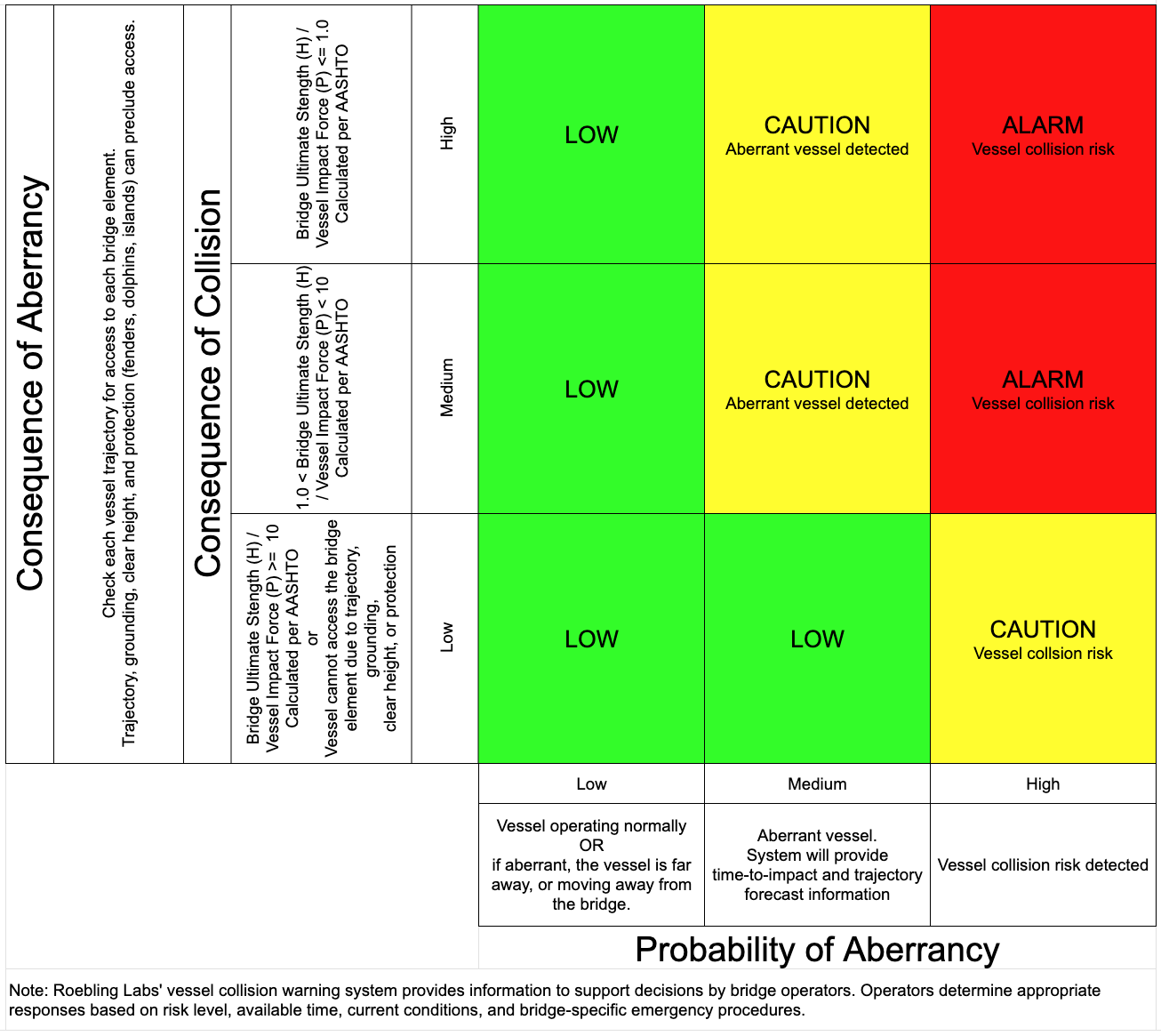

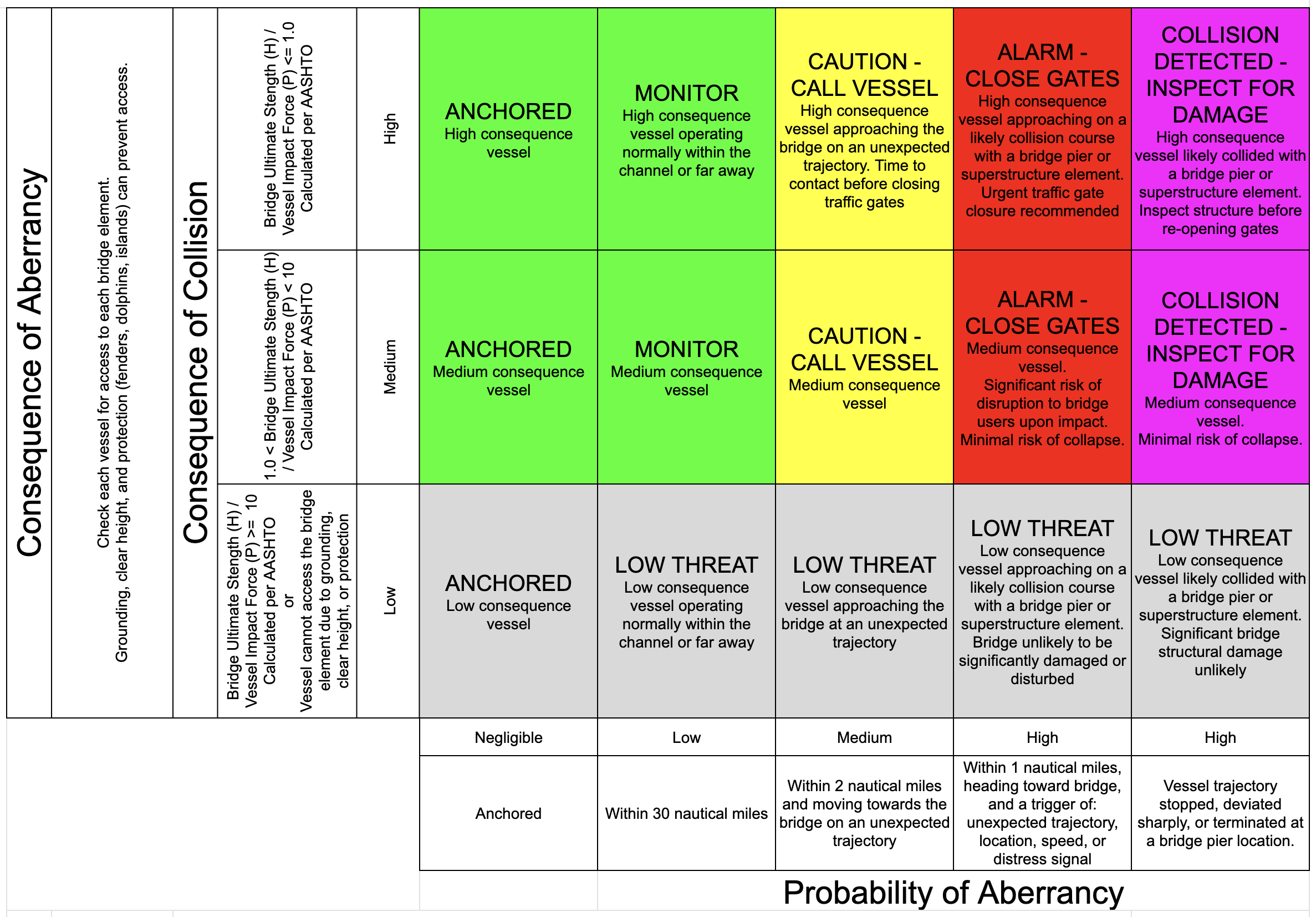

Figure 3: Risk Matrix for Assessing Vessel Threat

Resources

Case Study

Roebling Labs operates a demonstration vessel collision warning system deployed at a site adjacent to the Tobin Bridge in Boston, Massachusetts. Operational since January 2026, including through multiple blizzards, it has tracked hundreds of vessels. This system is a proof-of-concept deployment. Roebling Labs is actively developing and improving threat assessment algorithms using the real-world data gathered from this site.

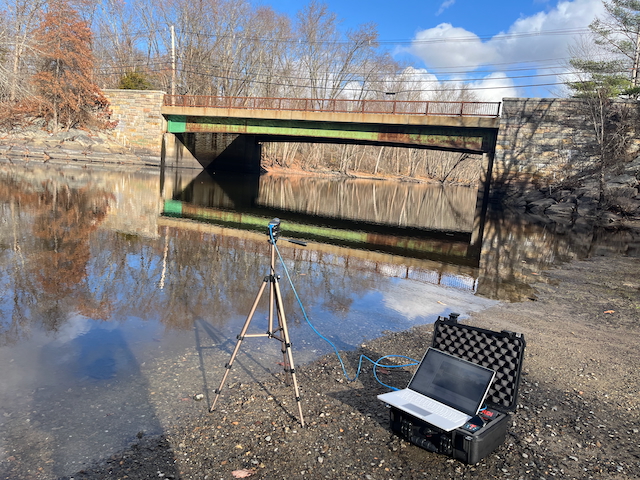

Hardware box

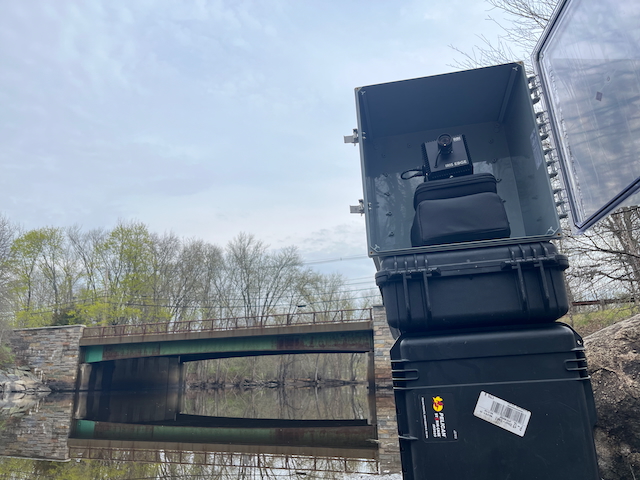

The hardware box, shown in Figure 4 below, is approximately the size of a shoebox plus an antenna. The antenna receives AIS transmissions from vessels. A computer inside processes the data and a cellular modem transmits relevant data to the cloud. The box is powered from a standard 120v outlet.

Hardware Box at Tobin Bridge

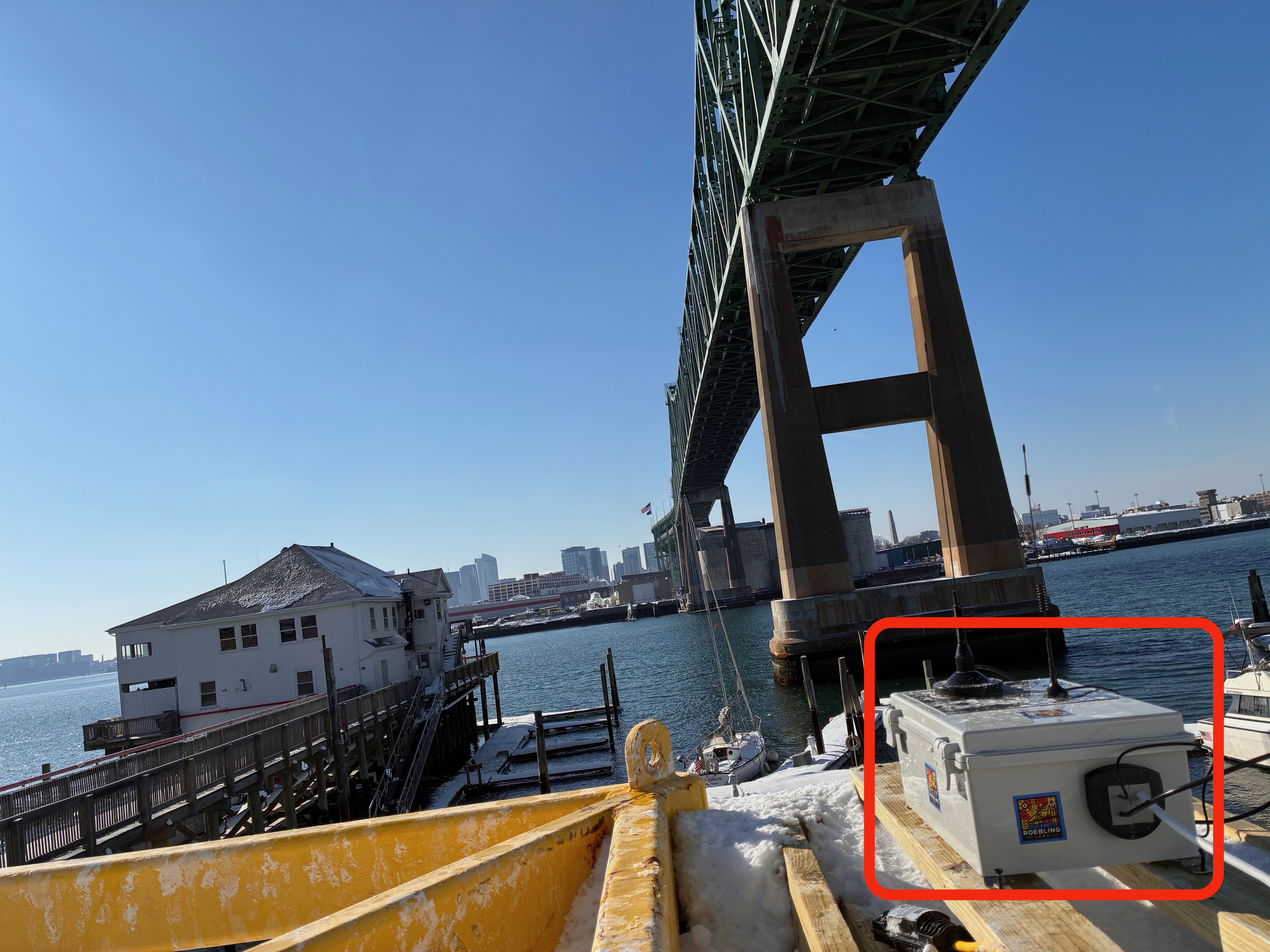

Figure 4 - Hardware Box at Tobin Bridge

Dashboard

The dashboard displays real-time information on local vessel traffic. In a production deployment, bridge operators use this interface to monitor approaching vessels and receive collision threat alerts. See Figure 5 screenshot below for an example dashboard.

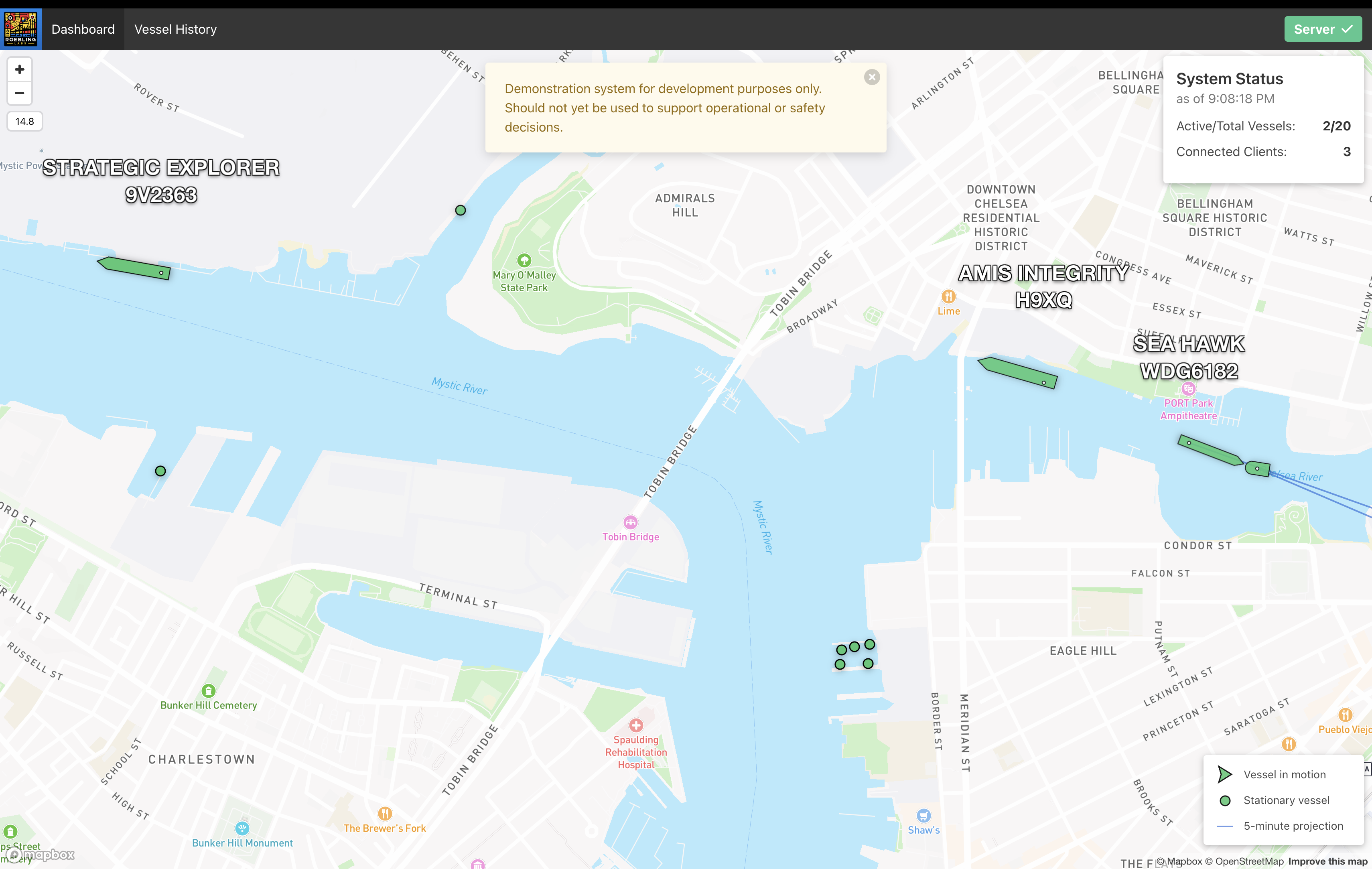

Screenshot of Dashboard at Tobin Bridge

Figure 5 - Screenshot of Dashboard at Tobin Bridge

Link to Live Dashboard — Explore the interface yourself.

Vessel history screen

The vessel history screen facilitates detailed searches of point-by-point data. In a production deployment, this tool supports detailed investigations of incidents, including collisions, near-misses, and false alarms. Vessel history data allows Roebling Labs to improve our threat assessment algorithm over time. As an example, users can compare forecasted versus actual trajectories. See Figure 6 for an example screenshot.

Vessel History Screen at Tobin Bridge

Figure 6 - Vessel History Screen at Tobin Bridge

Link to Vessel History Screen — Search Point-by-Point Data
